How Reliable Is Pneumatic Piercing? An Evidence Review of Accuracy, Ground Conditions, and Alternative Installation Methods

Pneumatic piercing can be highly repeatable on the right short crossing, but “reliable” is not a property of the tool alone. It is the result of a straight and measurable acceptance corridor, a stable launch, reasonably uniform displaceable ground, adequate cover, verified utility clearance, a maintained air system, and a recovery plan. Remove any one of those conditions and a method that looked simple on paper can become difficult to control.

For routes that pass that screen, GRUNDOMAT pneumatic piercing tools provide a range of tool sizes and configurations for short trenchless work. Model selection should come after the allowable line-and-grade error, product outside diameter, soil response, pit geometry, air demand, and fallback method have been defined. The practical question is not “Does piercing work?” It is “Can this specific setup keep this specific installation inside its required corridor?”

Reliability Is a Tolerance Question, Not a Reputation

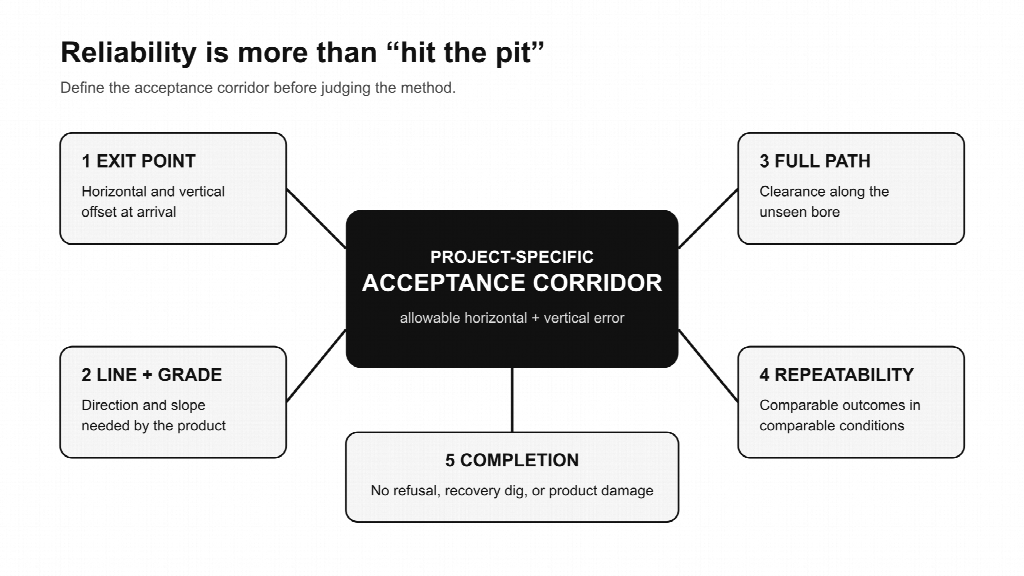

A useful reliability review begins by separating five outcomes that are often blended together:

  • Exit-point error: the horizontal and vertical difference between the planned and actual arrival point.
  • Line and grade: whether the tool follows the intended direction and slope closely enough for the product and connections.
  • Full-path clearance: whether the unseen bore remains outside required offsets from existing utilities, structures, pavement, and grade.
  • Repeatability: whether comparable launches in comparable ground produce comparable results.
  • Completion: whether the tool finishes the run without refusal, reversal, excavation, or product damage.

These measures answer different questions. A tool may arrive inside a broad receiving pit while missing a tight service connection. It may hit the target but pass closer to an existing utility than the exit point suggests. It may also maintain acceptable line and grade yet stop short because of a cobble or buried debris. Calling all three outcomes “accurate” hides the failure mode that matters.

The Trenchless Technology Center's Guidelines for Impact Moling says that, in stable ground and with proper initial alignment, a non-steerable mole can be expected to remain within 1% of bore length in line and grade. That statement is useful for preliminary planning, but it is not a universal average, a 99% success probability, or a warranty. The conditions attached to it—stable ground and proper alignment—are doing most of the work.

Translated into distance, a 1% reference gives the following offsets. Horizontal and vertical error should be considered separately.

Bore length

1% reference offset

20 ft

2.4 in

30 ft

3.6 in

40 ft

4.8 in

50 ft

6.0 in

Those values may be acceptable for a generous receiving pit and unsuitable for a narrow sleeve, a gravity service, or a congested corridor. The evidence review of pneumatic piercing accuracy makes the important distinction between a planning benchmark and a measured probability. A project should therefore define its own allowable corridor before deciding that the method is reliable enough.

A receiving pit can make performance look better than it is

If a receiving pit is 36 inches wide and the tool exits 10 inches from the planned centerline, the run may be recovered easily. Operationally, that may be a success. Geometrically, it is still a 10-inch offset. Recording only “arrived in pit” makes later projects appear more predictable than the underlying data supports.

The same issue applies to depth. Measuring entry and exit elevations does not prove the tool held a straight vertical profile between them. Where intermediate clearance is critical, the design must rely on verified separation, exposure, tracking where appropriate, or a different installation method—not on the receiving pit as evidence of the hidden path.

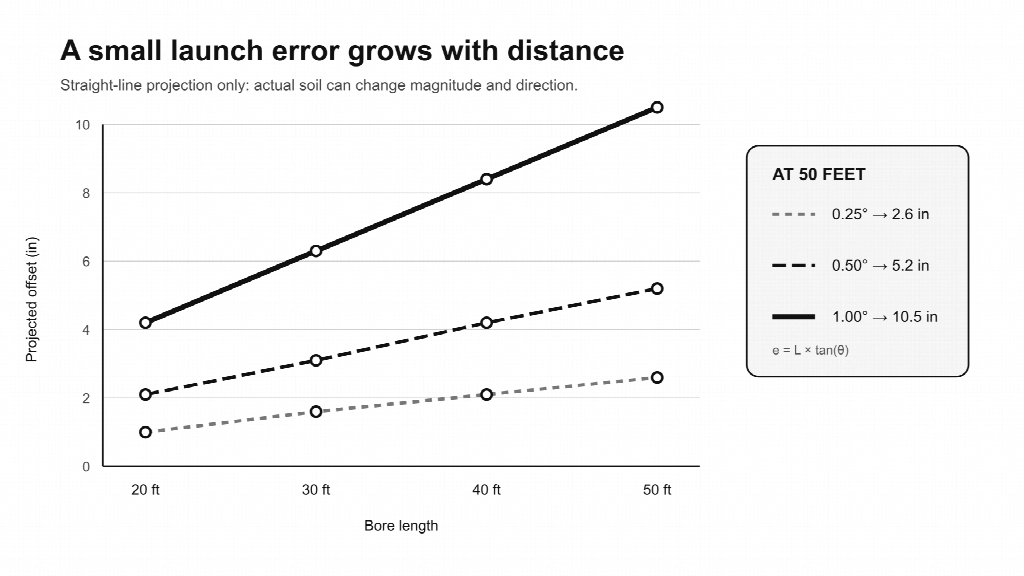

Launch Error Sets the First Accuracy Limit

An unsteered pneumatic tool carries the launch direction into the ground. Before soil variability is considered, a simple straight-line projection shows how quickly a small angular error grows:

Projected offset = bore length × tan(angular error)

Launch-angle error

20 ft

30 ft

40 ft

50 ft

0.25°

1.0 in

1.6 in

2.1 in

2.6 in

0.50°

2.1 in

3.1 in

4.2 in

5.2 in

1.00°

4.2 in

6.3 in

8.4 in

10.5 in

At 50 feet, a one-degree error projects to roughly 10.5 inches even if the tool follows a perfectly straight line. Real soil can increase that error, reduce it, or turn it in another direction. The calculation is not a prediction of the final path; it isolates the part of the result that the launch crew can control.

Alignment is a setup process, not a single reading

The launch and receiving pits need stable floors, sufficient length for the tool and alignment system, and an unobstructed reference line. A level placed on an unsupported tool is not enough if the cradle can settle, the pit wall can move, or the launch face crumbles as the nose enters.

Manufacturer operating guidance for conventional GRUNDOMAT tools instructs crews to start at reduced power and continue checking line and grade until the tool is fully in the ground. It also warns that the path cannot be corrected after full entry. That makes the first tool lengths a control window: movement can still be detected and the launch can be stopped before the alignment error becomes buried and expensive.

A defensible launch procedure records the planned bearing and grade, verifies the aiming frame against independent references, checks the tool during staged entry, and defines a stop limit. “Looks close” is not a measurable acceptance criterion.

Ground Conditions Decide Whether the Line Holds

Pneumatic piercing advances by compacting and displacing soil around the tool. It is therefore most predictable when the ground supplies reasonably uniform resistance and side support. The same mechanism becomes less predictable when the tool crosses materials with sharply different stiffness, density, particle size, or moisture.

Ground condition

Expected response

Reliability implication

Uniform clay or silt

Consistent confinement and resistance

Usually the best candidate after site verification

Very soft or saturated soil

Weak reaction; possible sinking, swimming, or oscillation

Increase uncertainty; assess dewatering and alternative methods

Loose sand or gravel

Inconsistent support and possible collapse

Greater deviation and settlement risk

Dense, dry, or cemented layer

High resistance

Refusal, slowdown, or deflection becomes more likely

Mixed fill or old trench

Tool may follow the softer zone

Direction can change at material boundaries

Cobbles, roots, debris, concrete

Local obstruction

Deflection, refusal, tool damage, or recovery excavation

Solid unfracturable rock

No practical displacement path

Conventional pneumatic piercing is generally unsuitable

Uniformity matters as much as the soil name

“Clay” is not a complete ground model. A route may begin in stiff native clay, cross a loosely backfilled service trench, encounter saturated material below a leaking main, and finish in compacted aggregate. Each transition changes the forces on the nose and body. A short bore through variable fill can be less predictable than a longer bore through uniform native soil.

Site history is therefore useful evidence. Previous trenching, demolished foundations, repaired pavement, tree lines, abandoned utilities, and drainage problems identify places where the subsurface may not match a general soil map. Test pits and safe exposures at critical locations reduce uncertainty more directly than a broad geotechnical description.

Case histories show possibility, not probability

A reported Iowa installation used a 2.5-inch tool for a 48-foot bore in black fat clay with groundwater close to the excavation depth. The pits were dewatered and the tool was supported with a cradle and aiming frame. At one monitored location, the measured depth differed from the expected depth by about six inches. The case is useful because it documents conditions and controls; it does not establish a typical six-inch error or a general success rate.

That is the right way to use project evidence: compare ground, tool, distance, support, and acceptance conditions. A successful bore in dissimilar soil is not proof that another route will behave the same way.

Equipment and Operating Condition Change the Outcome

Tool geometry, condition, and air delivery influence whether the tool can cycle consistently and resist small disturbances. TT describes the reciprocating stepped-cone head and long body of GRUNDOMAT tools as features intended to support directional stability. That is a manufacturer design claim, not independent quantified proof that every bore will meet a particular tolerance. Its value still depends on correct model selection and operating condition.

Select the exact system, not a nominal diameter

The product outside diameter and joint geometry determine the required bore and pulling arrangement. The soil determines how much displacement is reasonable. Cover limits, pit size, tool weight, launch support, and compressor demand then narrow the model choice. Two tools with a similar nominal diameter may differ in length, mass, airflow, stroke behavior, or accessory requirements.

The complete operating system includes the tool, hose, lubricator, regulator, couplings, control valve, compressor, lubricant, starting level or aiming equipment, pulling attachment or expander, handling equipment, and recovery hardware. A restrictive fitting, leaking coupling, contaminated lubricator, worn head, or damaged hose can reduce performance even when the compressor nameplate looks adequate.

Consistent cycling supports consistent movement

Pressure provides the operating force; airflow sustains the cycling rate. Static pressure with the tool stopped does not demonstrate that adequate air reaches the tool under load. Crews should verify the exact model's published pressure and airflow requirements, include simultaneous air users, inspect the full air path, and measure dynamic pressure while the tool cycles.

Too little delivered air can cause weak or irregular cycling. Excess pressure can damage equipment and does not correct an undersized hose or fitting. Poor lubrication accelerates wear and can make behavior deteriorate during the run. None of these problems creates a precise, predictable amount of deviation, but each reduces confidence that the tool will perform like the planned setup.

Cover and surface response need separate checks

The operator manual uses minimum working-depth guidance related to tool diameter for covered models. That requirement should not be confused with product burial depth or clearance from existing utilities; all three must be satisfied independently. Insufficient cover can increase heave or breakout risk, especially in hard or shallow ground. Greater cover, however, does not make an unverified utility crossing safe.

Existing Utilities Raise the Required Standard

Destination accuracy and utility clearance are not the same requirement. A six-inch possible exit offset may be acceptable in an empty lawn and unacceptable where the route passes close to a gas service, electrical duct, sewer lateral, foundation, or retaining wall. Because the tool is not steerable after entry, uncertainty must be reduced before launch rather than managed by correction underground.

In the United States, OSHA's excavation rule requires employers to determine estimated underground-installation locations before opening an excavation and to establish exact locations by safe and acceptable means as work approaches them. One-call marks are part of planning, not a substitute for positive verification where the bore enters a critical tolerance zone.

A practical route-control plan should include:

  1. Current records and one-call notification.
  2. Surface locating by qualified personnel, with marks and confidence recorded.
  3. Safe exposure of critical crossings to establish horizontal position, depth, size, and material.
  4. A bore profile that includes the tool envelope, expected uncertainty, product envelope, and required separation.
  5. Protected launch and receiving references that will not move during excavation or setup.
  6. Stop-work criteria for abnormal resistance, unexpected ground, loss of air, utility movement, heave, or uncertain tool location.

CGA best practices support stopping when an abnormal condition, unknown substructure, or hidden hazard appears and resuming only after the condition is positively identified and the plan is revised. Tracking equipment may help identify the position of a compatible setup, but tracking alone does not make a conventional pneumatic mole steerable. If continuous path control is essential, the method decision needs to change.

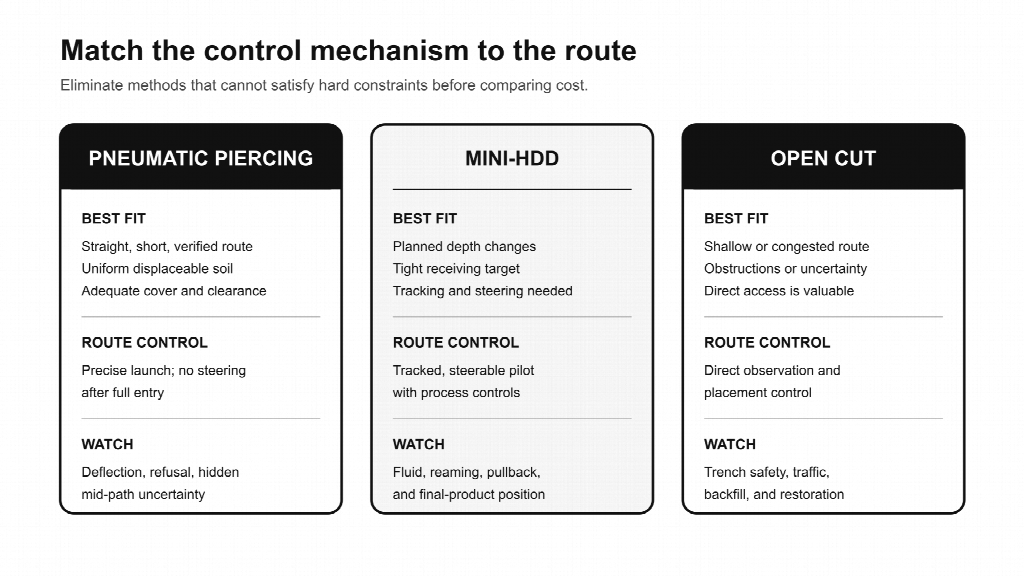

When Another Installation Method Is More Reliable

The most reliable method is the one whose control mechanism matches the route's dominant uncertainty. A concise comparison of pneumatic piercing, mini-HDD, and open cut helps frame the choice by ground, alignment, access, and consequence—not by bore length alone.

Pneumatic piercing: simple equipment, limited path control

Piercing is strongest when the route is straight, short, adequately covered, clear of close conflicts, and formed in verified uniform displaceable soil. It can minimize surface disturbance and use relatively compact support equipment. Its central limitation is equally clear: after full entry, the tool cannot be intentionally steered around an obstruction or corrected back to line.

Mini-HDD: active steering and tracking with a larger process

Mini-HDD is generally more defensible when the profile requires planned depth changes, the receiving target is tight, or tracking and steering are necessary. Those capabilities introduce their own controls: rig setup, drill-head geometry, bend radius, drilling fluid, locating accuracy, reaming, pullback load, and inadvertent-return risk. The final product in an enlarged bore may not occupy the exact pilot centerline, so steering does not eliminate the need for clearance design and verification.

Open cut: direct observation with greater surface impact

Open cut can provide the strongest direct control for shallow, congested, obstructed, or uncertain routes because the alignment and conflicts can be exposed. It also creates trench-safety, traffic, spoil, dewatering, backfill, compaction, pavement, landscaping, and restoration obligations. Where a utility conflict has severe consequences, those visible and manageable burdens may be preferable to an unobservable bore.

The decision should first eliminate methods that cannot meet hard constraints. Only then should the team compare production rate and installed cost. A cheap launch that ends in recovery excavation is not a cheap installation.

A Field Acceptance Plan for Pneumatic Piercing

A project can convert the evidence into a short release process. The objective is to decide whether piercing remains acceptable as uncertainty is removed—not to justify a method selected in advance.

Before mobilization

  • Define allowable horizontal and vertical error at the exit and along the route.
  • Define required separation from each known utility and structure.
  • Review records, surface evidence, site history, and available ground information.
  • Identify variable fill, groundwater, cobbles, roots, foundations, debris, and previous trenches.
  • Select a fallback method and a safe recovery location.
  • Confirm the exact tool manual, product compatibility, pulling configuration, cover, air requirement, hose, fittings, lubrication, and handling plan.

Before launch

  • Complete required notifications and expose critical facilities safely.
  • Measure and record launch and receiving pit geometry.
  • Establish independent bearing and grade references outside disturbed ground.
  • Inspect the tool and air path; verify dynamic performance under load.
  • Confirm that the tool envelope plus the uncertainty corridor remains outside every required clearance.
  • Brief the crew on reduced-power entry, check points, stop limits, communication, reversal, and recovery.

During the run

  • Check line and grade repeatedly while correction by relaunch is still possible.
  • Observe cycle consistency, advance rate, hose behavior, lubrication, ground movement, and utility exposures.
  • Stop for unexpected resistance, abrupt speed change, loss of air, surface heave, pit movement, utility movement, or loss of confidence in the tool path.
  • Do not treat extra air pressure as a correction for an obstruction or alignment problem.

At completion

  • Measure the exit offset from the planned line and grade; do not record only “hit pit.”
  • Inspect and test the installed product as required.
  • Record ground observations, interruptions, recovery actions, and tool condition.
  • Preserve as-built information and compare the result with the original acceptance corridor.
  • Feed measured outcomes back into future method selection only when the ground, tool, setup, and tolerances are comparable.

Pneumatic piercing is reliable when its limited control is sufficient for a verified route. The evidence supports disciplined use in uniform, displaceable ground with precise launch control and realistic tolerances. It does not support a universal accuracy percentage or blind confidence based on a successful exit. Define the corridor first, quantify the launch sensitivity, verify the ground and utilities, and choose another method when the consequence of an unseen deviation exceeds what the route can tolerate.
